Printer-friendly PDF →
                Strategy: Planning and Environment Linkages Peer Exchange
                Springfield, IL | December 10-11, 2018

                    This activity report summarizes the presentations and discussions. The summaries follow the order of appearance on the agenda. Each presentation summary is one page long, has a brief overview, findings, highlights from the participant discussion, and has a text box containing the speaker’s contact information. This peer exchange was funded through the Second Strategic Highway Research Program (SHRP2) product Expediting Project Delivery (C19).


                Source: Volpe Center
                Peer Exchange Notes

                    This peer exchange discussed Planning and Environment Linkages (PEL) approaches and focused on applying PEL to the I-80 bridge project on the Illinois-Iowa border. Seventy-eight stakeholders from Illinois
                    DOT, Iowa DOT, resource agencies, and
                    FHWA
                    headquarters and division offices attended the peer exchange. Colorado DOT served as the peer for this peer exchange and shared their experiences with PEL throughout the peer exchange to guide Illinois DOT in thinking about the I-80 PEL project.


                    Key Issues


                    Participants shared information on PEL approaches and worked to scope and identify needs for the I-80 PEL study.


                    Products


                    Participants defined a list of existing resources that can be used in the I-80 PEL study. Participants also identified required information that must be incorporated into the I-80 PEL study as it is undertaken.


                    Next Steps


                    Illinois DOT will move forward with the I-80 PEL study.



                    For More Information

                        Contacts

                            Marisel Lopez-Cruz
                            Planning and Environment Linkages Program Co-Lead
                            FHWA Office of Project Development & Environmental Review
                            (407) 867-6402 | Marisel.Lopez-Cruz@dot.gov

                        Resources




                            David Williams
                            Expediting Project Delivery Program Lead
                            FHWA Office of Project Development & Environmental Review
                            (202) 366-4074 | David.Williams@dot.gov

                        Presentations referenced in this document are available upon request to Madison.Burke@dot.gov.



                What is PEL?


                        Contact
                        Marisel Lopez-Cruz
                            Jody McCullough



                        Organization
                        FHWA Office of Environment
                            FHWA Office of Planning


                    Presentation Summary Provided an overview of what PEL is, how PEL can accelerate project delivery, background information on PEL, the benefits of PEL, and regulatory information on PEL approaches


                        Phone
                        (407) 867-6402
                            (202) 366-5001



                        Email
                        Marisel.Lopez-Cruz@dot.gov
                            Jody.McCullough@dot.gov




                    Presentation Highlights

                        - PEL uses the information, analysis, or products developed during planning to inform the environmental review process.
- PEL is authorized under multiple statutory authorities, the most recent authorities being:

                - 23
                    USC
                    168 outlines conditions for adopting or incorporating by reference a planning product.
- 23 USC 139(f)(4) describes requirements for eliminating alternatives if studied in planning.

- Many conditions for PEL are already completed as part of the normal transportation planning process.
- One Federal Decision sets a goal of reducing the average time for environmental review for major infrastructure projects to two years:






                    CDOT
                    PEL Study Framework & Resources


                        Contact
                        Sean Brewer



                        Organization
                        Colorado Department of Transportation


                    Presentation Summary CDOT leads a PEL program that focuses on larger-scale PEL studies. CDOT has completed 20 PEL studies since 2008. Through PEL, CDOT engages resource agencies and has found success with its Transportation Environmental Resource Council (TERC).


                        Phone
                        (303) 757-9978



                        Email
                        Sean.Brewer@state.co.us




                    Presentation Highlights

                        - CDOT’s PEL program focuses on fostering agency outreach, environmental scoping, and mitigation opportunities.
- The PEL process is flexible and can be used to make project or planning decisions.
- If a program or project is likely to have federal involvement in the future, PEL is a good tool to help streamline future National Environmental Policy Act (NEPA) processes.
- CDOT data from PEL studies can be used in NEPA if less than 5 years old.

                    Source: CDOT
                    Participant Discussion Highlights

                        Partner Engagement


                        Engaging resource agencies over years and establishing formal structures for engagement builds trust in the process.


                        Public Involvement


                        Public involvement is flexible in PEL. CDOT uses kickoff meetings and open project comments on their website and seeks to keep an open and transparent process through PEL.


                        Realizing Benefits


                        PEL is beneficial when construction money is not available. It is also beneficial to establishing a reasonable range of alternatives while eliminating unreasonable alternatives before NEPA.





                Adopting PEL Approaches to
                    IDOT
                    Processes and Projects


                        Contact
                        Janel Veile



                        Organization
                        Illinois Department of Transportation


                    Presentation Summary Participants received an overview of the I-80 bridge project, which will be a PEL study. Participants then discussed the PEL study’s purpose and need, logical termini, and range of alternatives. Participants also identified existing resources that can be used in the PEL study and new information that will need to be identified during the PEL study.


                        Phone
                        (217) 558-7223



                        Email
                        Janel.Veile@illinois.gov




                    Discussion Highlights

                        - Illinois DOT will conduct a PEL study on the I-80 bridge linking Illinois and Iowa.

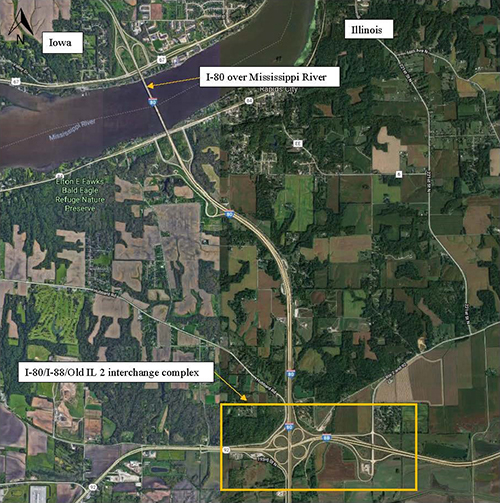

                    Source: Illinois DOT
                    Products Identified

                        - Through the discussion, participants identified the following resources to be used in the PEL study:

                - A bridge inspection report for the I-80 bridge.
- Preliminary assessments of geometry.
- Crash data for the study area that can be used by the project consultant in a crash analysis.
- Travel demand model and analysis already conducted by Quad Cities MPO.

- Participants also identified the following pieces of information needed in the PEL study:

                - Logical termini for the study area.
- A traffic analysis to assess safety issues along the corridor.
- Railroad interaction and bicycle/pedestrian issues will require study.
- Environmental Justice communities and tribes will need to be identified and consulted.
